The Definitive Guide to Industrial Steel Tank Installation
Success in steel tank installation isn’t determined on the day the crane arrives; it’s won weeks in advance during the coordination phase. At Tank Depot, our project management team, led by Jessica Moss, utilizes a rigorous pre-arrival framework to ensure that when your steel water storage tank hits the site, the "chain reaction" of progress is seamless.
Structural Site Readiness
Before the first steel plate is unloaded, the site must meet specific engineering thresholds. This is the foundation of a successful steel tank installation guide:
- Compaction Testing: Ensuring the soil or sand pad meets the specific PSI requirements for the weight of a fully loaded tank.
- Clearance Zones: Identifying overhead obstacles (power lines, tree branches) and ensuring a 360-degree "swing zone" for SkyTracks or cranes.
- Access Routes: Can a 53-foot flatbed reach the pad? If the site is uphill or steep, specialized equipment must be staged Day 1.
The Orientation Flange & Fitting Form
The most common cause of steel water tank installation delays is a fitting that doesn’t align with existing piping. To eliminate this, we provide an Orientation Flange Fitting Form.
- What it is: A precise schematic where you map the exact clock position (e.g., "Inlet at 3 o'clock, Drain at 9 o'clock") of every fitting.
- The Benefit: By confirming these dimensions before the steel tank is bolted or welded, we ensure that your plumbing mates perfectly with the tank on the final day of installation, preventing on-site modifications that void warranties.
Critical Resource Coordination
A professional steel tank installation requires more than just steel. We coordinate with you to ensure:
- The Hydro-Test Water Source: You must have the volume ready (often tens of thousands of gallons) to begin the leak test immediately following assembly.
- Equipment Staging: Confirming the rental and arrival of jacks, lifts, and seismic-rated drilling tools.
What are the Foundation Requirements for Steel Tank Installation?
A common industry mistake is assuming a "one-size-fits-all" approach to foundations. Depending on the tank’s weight, material, and whether it is above or below ground, the engineering requirements shift significantly.
Above Ground Foundations: Sand Pads vs. Concrete Ring Beams
For above ground steel tank installation, the foundation must distribute the immense hydrostatic pressure of the stored liquid while preventing "settling" that can stress the steel seams.
- Concrete Ring Beams: This is the gold standard for large-diameter bolted steel tank installation. A reinforced concrete ring supports the heavy outer walls (where the weight of the steel and roof sits), while the center is filled with compacted sand or gravel to support the floor.
- Full Concrete Pads: Essential for carbon steel tank installation and NFPA 22 fire suppression tanks. These pads must be engineered to a specific PSI (usually 3,000–4,000) and must be perfectly level within 1/8th of an inch across the entire diameter to prevent structural torque.
- Compacted Sand Pads: Frequently used for smaller corrugated steel storage tanks. While cost-effective, the sand must be non-corrosive and contained within a pre-cast or poured curb to prevent washout.
Underground Steel Tank Excavation (UST)
When moving to underground steel tank installation, the challenge shifts from support to stability and buoyancy control. Following the standards set by manufacturers like Newberry Tanks and FGT Solutions, site prep includes:
- The Excavation Zone: The hole must be significantly larger than your steel fuel storage tank (typically 18–24 inches of clearance on all sides) to allow for proper backfill compaction.
- Bedding Materials: Unlike above ground tanks, USTs require specific bedding like pea gravel or crushed stone (no larger than 3/4 inch). This allows for drainage and prevents "point loading" on the steel hull.
- The "Wet Hole" Protocol: If groundwater is detected, dewatering pumps must be active throughout the steel tank installation to prevent the tank from shifting or "floating" before it can be anchored.
Advanced Anchoring: Seismic and Wind Load Protocols
In specific geographic regions, a standard pad isn't enough. Your steel tank installation guide must account for environmental forces like earthquakes or tornadoes.
The Seismic Anchor Process
In seismic zones, the connection between the installed steel tank and the pad is the most critical failure point.
- Drilling and Clearing: Holes are drilled into the concrete pad following the tank's footprint.
- Two-Part Epoxy Injection: A specialized two-part epoxy is injected into the hole using a dual-cartridge gun. This creates a chemical bond that is significantly stronger than a mechanical anchor alone.
- The Bond: Once the anchor is set in the epoxy, it hardens into a rigid, permanent unit, ensuring the tank stays upright during ground movement.
Wind Anchors for Corrugated Tanks
Because corrugated steel storage tanks are lighter when empty, they are susceptible to "wind walk" during the assembly phase. Temporary anchoring or "water weighting" (filling the tank partially as you build) is a non-negotiable step to maintain site safety.
Installation Requirements by Tank Type
| Feature | Corrugated Storage | Tanks Carbon Steel (Welded/UST) | Stainless Steel Storage |
| Foundation Type | Sand Pad or Concrete Ring | Reinforced Concrete Pad | Concrete or Steel Stand |
| Primary Assembly | Bolted / Hydraulic Jacking | Field-Welded / Crane Set | Factory-Welded or Bolted |
| Sealing Protocol | Flexible Internal Liner | Continuous Weld (V-Groove) | Gasketed Bolts or Welds |
| Integrity Testing | Hydrostatic Leak Test | NDT / Vacuum Box Testing | Hydrostatic Leak Test |
| Corrosion Defense | Galvanized + Liner | Epoxy Coating / Cathodic | Natural Chromium Oxide |
| Seismic Strategy | Two-Part Epoxy Anchoring | Heavy-Duty Lugs & Epoxy | Mechanical or Epoxy |
The Precision Build: Step-by-Step Assembly
A professional steel water tank installation is executed in distinct phases. This ensures that the tank is built level, sealed correctly, and anchored securely before it is ever filled with product.
Phase 1: Inventory and Site Staging
Day one of any bolted steel tank installation is dedicated to inventory management. Because these tanks consist of hundreds of standardized panels and thousands of high-tensile bolts, a single missing crate can halt the entire project.
- Component Verification: Every steel plate, truss, and hardware box is cross-referenced against the packing list.
- Staging: Materials are organized around the perimeter of the pad to minimize crane movement and maximize workflow efficiency.
Phase 2: The Foundation Ring and Internal Logistics
Construction begins with the assembly of the first (bottom) ring of steel panels. However, the most critical step in this phase is "loading" the tank.
- Hardware Staging: Before the second ring or roof is installed, all internal hardware, including trusses, rafters, and the liner (if applicable), is moved into the center of the first ring.
- The Benefit: Once the tank begins to rise, moving large components through a manway becomes impossible. Pre-loading the interior ensures a seamless assembly as the bolted steel tank gains height.
Phase 3: The Hydraulic Jacking Method
For large-diameter bolted steel tank installation, we utilize a specialized "Top-Down" jacking method. Instead of workers climbing high scaffolding, the roof and top ring are built first at ground level.
- Synchronized Lifts: High-capacity hydraulic jacks are positioned around the interior circumference.
- The Process: Once the top ring and roof are completed, the jacks lift the structure exactly one panel-height. The next ring of panels is then bolted on at chest height. This process repeats until the tank reaches its full design height, significantly increasing safety and speed.
Sealing and Integrity: Liners vs. Welds
Depending on the material, corrugated, galvanized, or carbon steel, the method for ensuring a leak-proof environment differs.
The "Bag" Protocol: Liners for Corrugated and Galvanized Tanks
For modular corrugated steel tanks, the liquid is held within a heavy-duty flexible liner.
- Suspension and Taping: The liner is carefully unrolled and suspended from the top ring. To prevent leaks at connection points, Butyl tape and high-grade industrial sealants are applied to every flange and bolt penetration.
- The Vacuum Seal: During the final stages of the bolted steel tank installation, the air is often vacuumed out from between the liner and the steel shell to ensure the "bag" sits perfectly flush against the walls, preventing wrinkles that could lead to stress fractures.
Field-Welding and NDT for Carbon Steel Tanks
Unlike a bolted steel tank installation, carbon steel vessels are often joined via field-welding.
- Continuous Seams: Professional welders create full-penetration V-groove welds to join the heavy plates.
- Non-Destructive Testing (NDT): Once welding is complete, the seams undergo NDT, such as Vacuum Box testing or Ultrasonic testing, to ensure there are zero porosities or defects in the weld before the steel tank is coated and put into service.

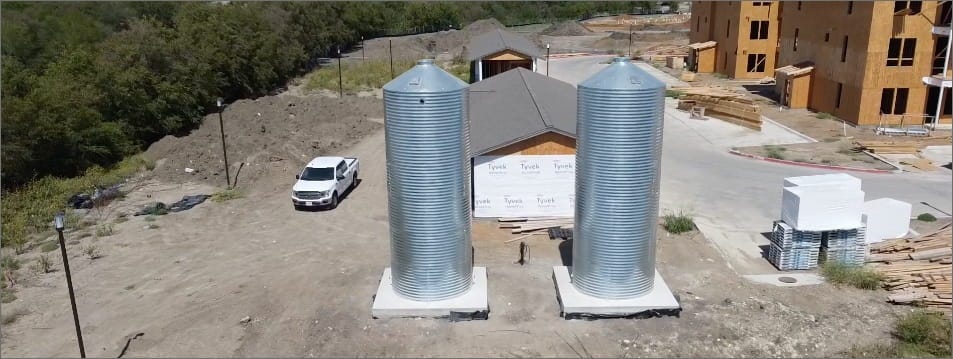

Engineering for High-Stakes Environments
Geography plays a massive role in the final stages of the build. Whether you are operating in a coastal salt-air environment or an earthquake-prone region, your steel tank installation guide must prioritize structural anchoring and material-specific protection.
Seismic Stability: The Two-Part Epoxy Anchor Protocol
In high-seismic zones, mechanical expansion anchors are often insufficient for the sheer forces exerted by a shifting, liquid-filled mass. We utilize a chemical bonding process that ensures the tank and the foundation act as a single unit.
- Precision Drilling: After positioning your steel tank, bore holes into the concrete pad to an exact depth calculated by the engineering team.
- The Epoxy Injection: We use a specialized dual-cartridge gun to inject a high-strength, two-part epoxy resin into the clean boreholes.
- The Bond: Unlike mechanical bolts that rely on friction, the epoxy creates a chemical weld between the anchor and the concrete. This prevents the "prying" effect during seismic vibrations, keeping the steel tank installation securely seated.
Managing Corrosion: Stainless Steel vs. Coated Carbon
Choosing the right material for your environment is the first step in corrosion control.
- Stainless Steel Tanks: For many industrial and potable water applications, stainless steel tank installation is considered a "set and forget" solution. The chromium-rich oxide layer provides natural protection against oxidation without the need for external coatings.
- Carbon Steel Tanks: Carbon steel offers immense structural strength but requires an active defense strategy. These tanks are typically finished with high-performance epoxy coatings or glass-fused finishes to create a barrier between the steel and the elements.
Advanced Corrosion Defense for Underground Steel Tanks (UST)
When the installation is subterranean, the risk of galvanic corrosion increases due to soil conductivity and moisture.
Cathodic Protection Installation for Steel Tanks
For underground carbon steel vessels, a high-quality coating is only the first line of defense. To truly prevent the hull from weakening over time, a cathodic protection installation for steel tanks is required.
- Sacrificial Anodes: By attaching magnesium or zinc anodes to the tank, we create a "sacrificial" circuit. The corrosive current attacks the anodes instead of the steel hull, significantly extending the life of the steel tank installation.
- Impressed Current Systems: For larger industrial tank farms, an impressed current system may be used to provide a constant protective electrical charge to the steel, ensuring zero-corrosion integrity for decades.
The "Golden Rule" of Steel Tank Installation: Project Organization
Technical specs mean very little if the logistics fail. In our experience, the single greatest factor influencing the final cost of a steel tank installation is not the material or the labor. It is organizational synchronicity.
Without a rigid organizational framework, a project can suffer a "chain reaction" of delays. For example, if a manufacturer sends the wrong roof trusses, it doesn't just delay the roof; it halts the crane schedule, pushes back the hydraulic jacking crew, and forces a rescheduling of the thousands of gallons of water required for the hydrostatic test. To maintain a seamless workflow, we adhere to three organizational pillars:
- Inventory Synchronization: Every bolt and plate is cross-referenced on Day 1. Discovering a missing component on Day 4 is a failure of organization that leads to thousands in "wait-time" costs.
- Vendor Alignment: Coordinating the arrival of the SkyTrack, the crane, and the water trucks requires a central "Source of Truth" document that all parties can access.
- The Contingency Buffer: A professional steel tank installation guide always accounts for a "buffer day" to handle unforeseen site obstacles like uphill equipment transport or weather-related delays.
Setting the Standard for Industrial Storage
A successful steel tank installation is an exercise in meticulous coordination and engineering discipline. From the moment our pre-arrival checklist is initialized to the final torque of a seismic anchor, every step must be executed to prevent the "chain reaction" of delays that are the primary driver of cost overruns.
By prioritizing foundation integrity, utilizing the hydraulic jacking method for bolted steel tank installation, and implementing material-specific corrosion defenses, you ensure that your facility is equipped with a reliable, high-performance storage asset. At Tank Depot, we don't just supply the steel; we provide the strategic framework for a flawless execution. Frequently Asked Questions (FAQ)
